Possessing valuable experience in project management, budget control, combined with the rich experience of parent company Daewoo E&C: we confidently offer a management plan that combines rigor at each stage while ensuring the practical application of the construction team’s capacity.

Throughout the construction & construction process, Daewoo E&C Vina always accompanies and controls the quality of the work to ensure the original agreement.

PROJECT

STARLAKE

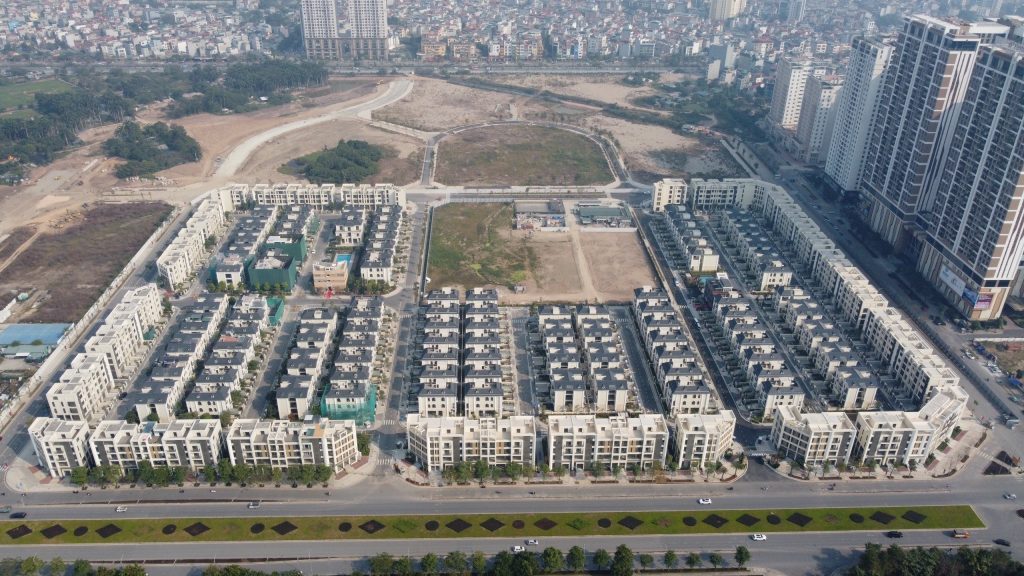

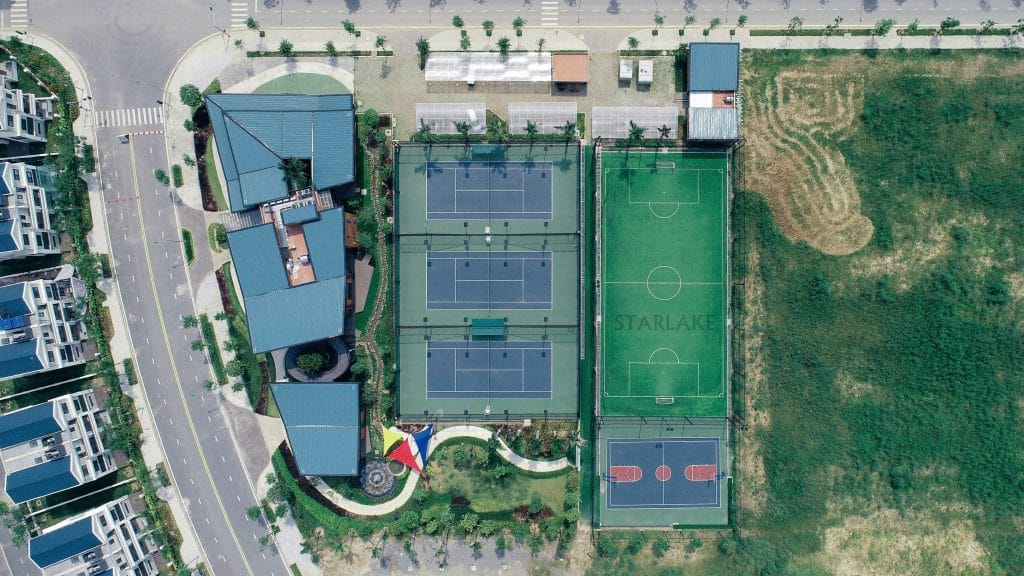

DECV is a general construction contractor of STARLAKE Project with 186ha area, supervising and managing construction quality for the following projects, ensuring construction quality meets international standards and conforms to construction design.

1st Phase Infra

Starlake Phase 1 Infra: 110ha contruction completed
Construction Period: 2.2014 – 9.2019

H Block Villas

Phase 1 Villa: H7, H6, H10
Total: 364 Units: Villas, Shophouse, Garden House
Construction Period: 2014 ~ 2019

H9CT1 STARLAKE APARTMENT

Total: 603 Units, 3 Towers, 24 Floors & 2 Basement
Area: 2.5ha
CFA: 145,198m2
Construction Period: 3.2018 ~ 10.2020 (32 months)

2nd Phase Infra

Starlake Phase 2 Infra: 70 ha
Construction Period: 8.2019 – 12.2025

K Block Villas

Phase 2 Villa: K3, K5&K7

– K3: 107 Units
CFA: 37,405 M2
Construction Period: 12.2019 ~ 5.2021 (18 months)

– K5&K7: 119 Units
CFA: 47,671 M2
Construction Period: 4.2021 ~ 11.2022
